Kansas State Bands

Tracz Family Band Hall Updates

Construction has finally begun on our new home!! Check back often for updates on construction on the Tracz Family Band Hall!

Click here for a great article on the construction progress on the TFBH from the K-State Alumni Association!

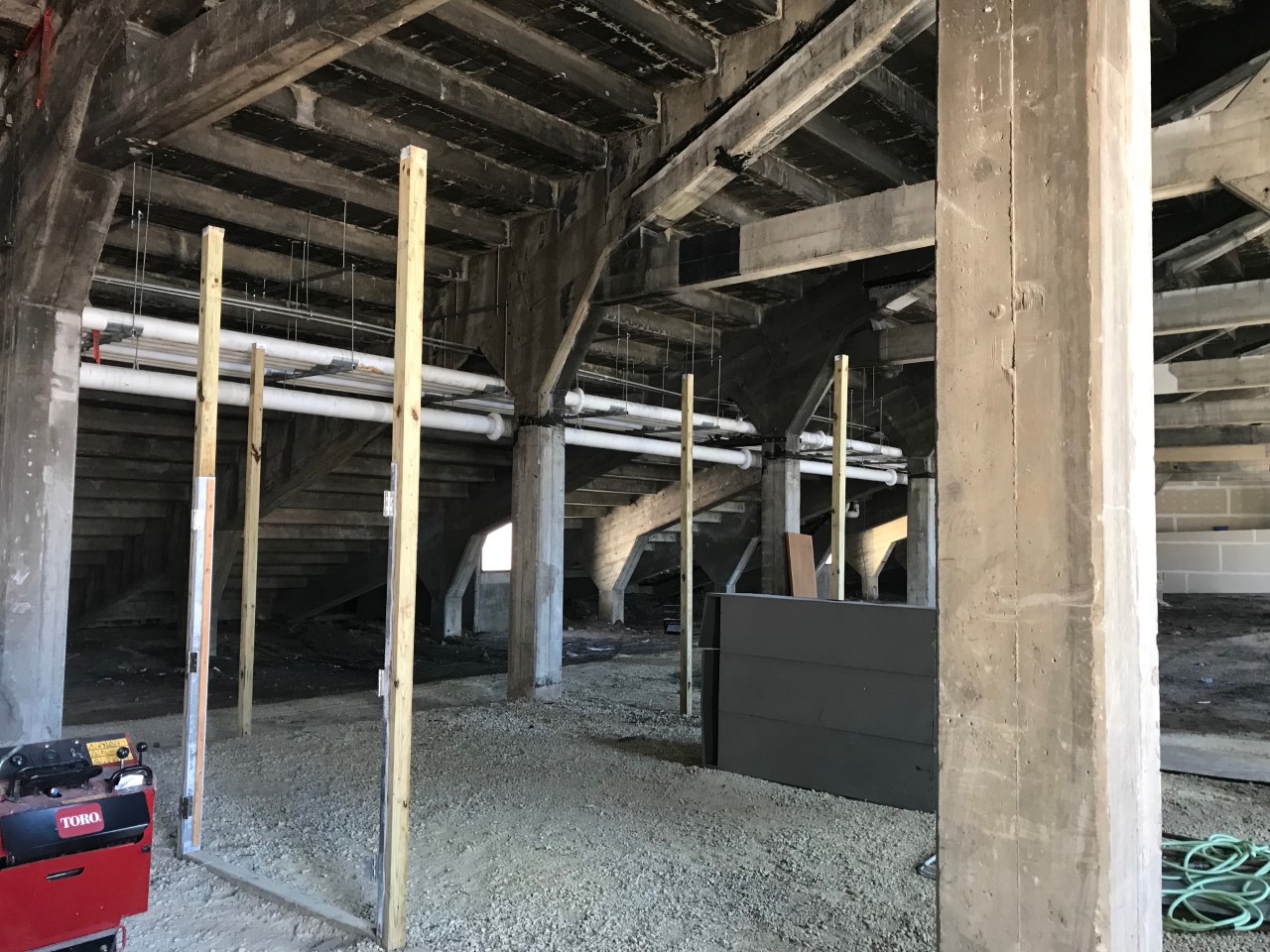

9/15/22 - Walls are coming down, cleaning out interior.

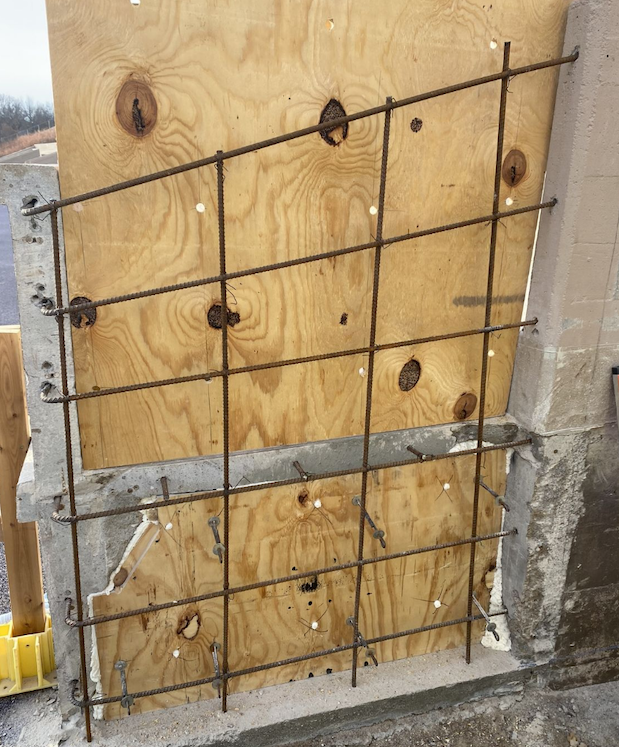

9/20/22 - Installing reinforcement posts.

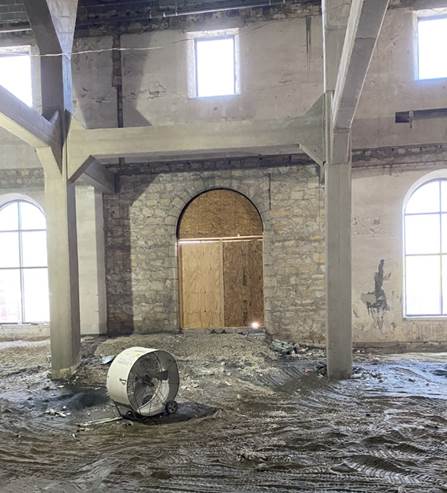

10/7/22 - Sandblasting the interior.

10/21/22 - Knocking down walls, laying pipe and hoses, and a new fence wrap for the construction site!

10/24/22 - We completed the remaining demolition work by removing the last of the existing concrete floor slabs.  We also are nearly done with demolition to create the new field access portals.  This involved removal concrete walls, slabs, and excavation.  And, with the release of permit status, the mechanical and electrical contractors were able to begin underslab plumbing and electrical rough-in.  These contractors really did a nice job and hit the ground at full stride.  Because of that, their underslab rough-in work completed in less days that originally planned.

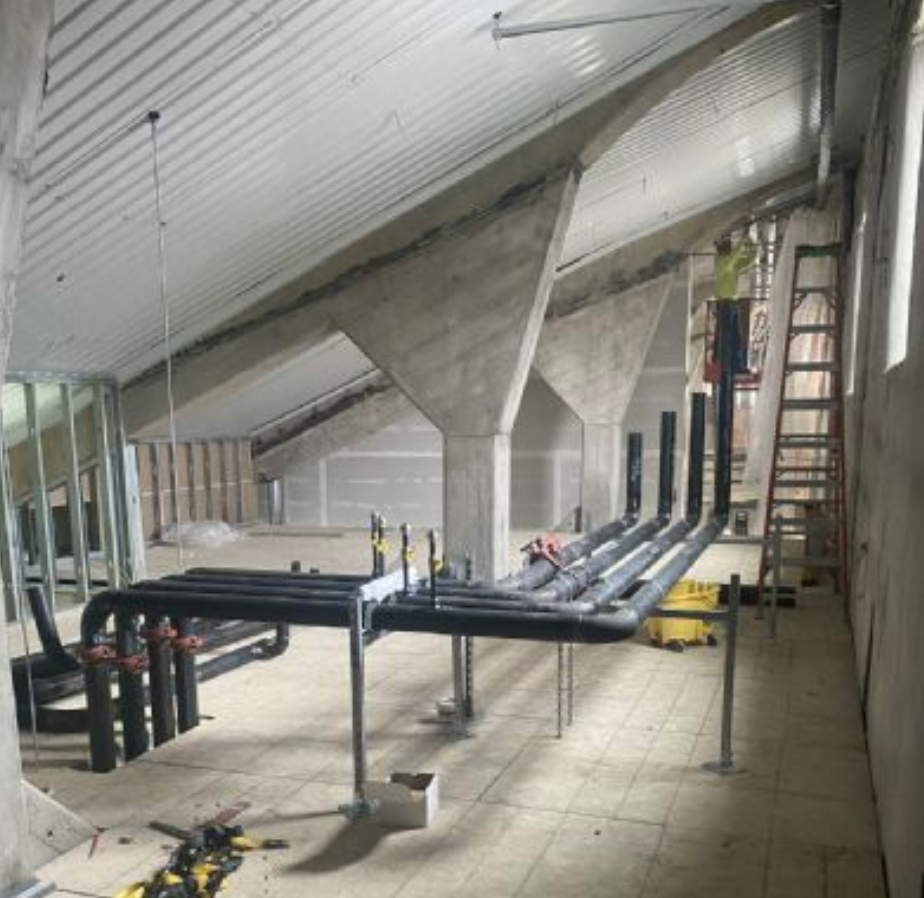

11/4/22 - Completed two concrete slab-on-grade sections, and the third and final section will be completed this week. Plumbing underslab rough-in work was completed ahead of the concrete work. Electrical underslab rough-in work also completed ahead of the concrete slabs. Demolition work wrapped up for the field access openings. Structural framing support material has been started ahead of the water shed metal ceiling structure. Every existing concrete step is slightly different dimension and deflects at different rates so aligning this system takes great care and time. Mechanical contractors are currently working on support hangers for some of the heavy ductwork and piping throughout the new buidling.

11/14/22 - More work on the concrete slabs is finally finished! Currently working on finishing the last bit of concrete for the walkway to Memorial Field. Also tying up the last bit of metal supports for the secondary ceiling as well! The "Director's Office" is coming along nicely (with windows for the first time!!)!

11/18/22 - Construction crews from Hutton completed the remaining floors slabs including ramps and stairs which create the elevation changes necessary to tie into the surrounding site conditions. It’s nice to walk on firm ground instead of dirt! Structural framing support material continued ahead of the water shed metal ceiling structure.  These provide support for an internal metal ceiling system.  They also provide elevation control for all future ceiling systems. Mechanical contractors are currently working on support hangers for some of the heavy ductwork and piping. The insulation contractor mobilized this week and started spraying foam insulation directly to the concrete risers.  This is sprayed to different thicknesses depending on what part of the building they are applying. Hutton’s crews also mobilized last week to start installation of metal ceiling systems.  This is an internal metal roof system that is installed to provide protection in case the green roof system overhead fails. This is certainly a unique application and approach that is somewhat hard to describe even to our installers because they are typically working on the top side of these materials, not from the bottom.

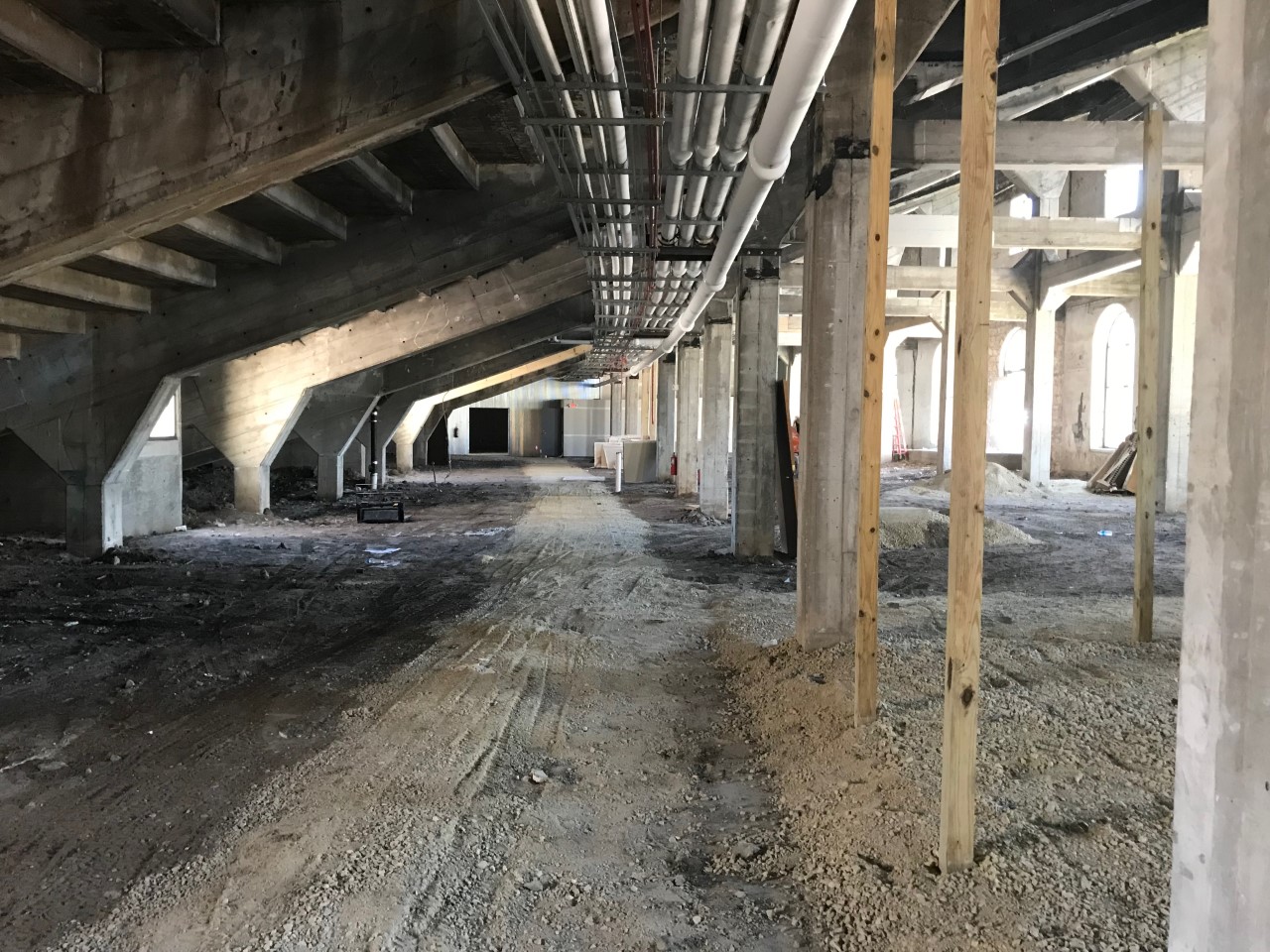

12/19/22 -

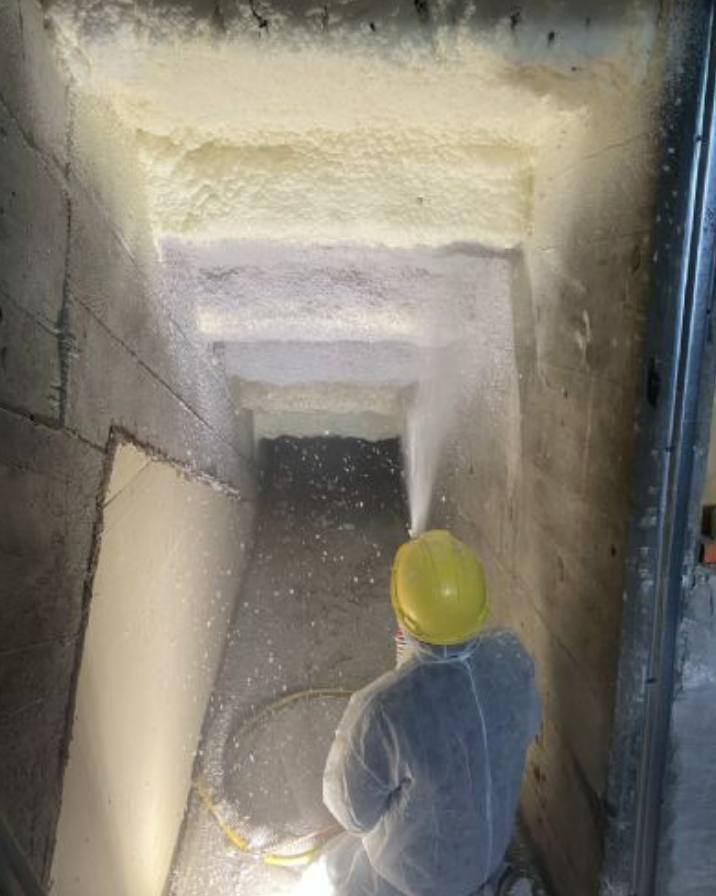

The insulation contractor completed their spray insulation work on the concrete stairs and riser sections. Hutton’s crews continued installation of metal ceiling systems.  This is an internal metal roof system that is installed to provide protection in case the green roof system overhead fails.  This work will continue for 3-4 more weeks. Logan (Site Superintendent) is meticulously coordinating locations for all the lighting, acoustical, ductwork, and other overhead systems so there will be proper supports in place and in the exact right locations.  This is important to make sure they are in the correct position and also to work through conflicts months before we complete final installation. Plumbing roughin work is started in the future restroom areas Wall framing is started for future wall locations.

Next week’s plans:

Work will continue on the metal ceiling system. Mechanical and electrical hanger supports will continue after the metal panel installation.  These are hangers for lighter support loads that don’t need to penetrate through the metal panel system. Metal framing for walls will continue. A mezzanine structure will be installed over the front office area.  This will support mechanical equipment scheduled to arrive in early January.

12/23/22:

Hutton’s crews continued installation of metal ceiling systems. This is an internal metal roof system that is installed to provide protection in case the green roof system overhead fails. This work will continue for 2 more weeks. Plumbing roughin work continues in the future restroom areas. The chilled water service main expansion loops were adjusted to slope with the roof structure. Wall framing continued for future wall locations. Mezzanine steel framing started this week. HVAC ductwork started in areas that won’t conflict with future acoustical treatments. Hutton and Architect One coordinated final location of the Instrument Storage cabinetry.  Space is tight in these areas and getting all the ceiling, soffit, electrical, and fire protection items positioned is meticulous work.

 Next week’s plans:

Work will continue on the metal ceiling system. Mechanical and electrical hanger supports will continue after the metal panel installation. These are hangers for lighter support loads that don’t need to penetrate through the metal panel system. Metal framing for walls will continue. The mezzanine structure will be completed ahead of mechanical units scheduled to arrive in early January. Fire protection support hangers and branch lines will begin.

1/8/23 -
Hutton’s crews are nearly complete with the metal panel interior roof system.  All that is left to complete is the gutter system and connections to drains. Plumbing rough-in work continues. Wall framing continued for future wall locations, now 50% complete and heading south through the space. Mezzanine construction is completed with framing and floor decking in place. HVAC ductwork continued in areas that won’t conflict with future acoustical treatments. Mechanical equipment pads were installed for equipment.

Next week's plans: Work will complete on the metal ceiling system. Mechanical and electrical hanger supports will continue after the metal panel installation. Metal framing for walls will continue at the south end of the project. Mechanical units are scheduled to arrive on site on Tuesday.  These are shipped in 16 pieces that then must be re-assembled on site into 3 large units.  The small pieces were needed to fit through the existing building openings. Fire protection support hangers and branch lines will begin. Drywall installation will begin at the top of walls ahead of acoustical spray. Acoustical ceiling sprayed treatment will begin below the metal panel ceiling.  This will create many of the finished ceilings for the space.

1/23/23 - This past week on the Band Hall Project: Hutton’s crews completed the metal panel interior roof system. Plumbing systems are being insulated. Wall framing continued for future wall locations, now 75% complete and heading south through the space. Drywall installation started on high walls ahead of ceiling texture and large mechanical systems. HVAC ductwork continued in areas that won’t conflict with future acoustical treatments. Air handling units were installed in 2 of the 3 unit locations. Fire protection materials were sprayed at the low portions of the building. Acoustical spray started at high ceiling spaces along the west wall of the building.

Next week’s plans: Fire protection piping will be installed. Metal framing for walls should complete. Drywall installation will continue the top of walls ahead of acoustical spray. Acoustical ceiling sprayed treatment will continue below the metal panel ceiling. This will create many of the finished ceilings for the space. Door frames will be set in place.

2/6/23 -This past week on the Band Hall Project: For those of you who have been on site in the last week or two, you already know what the big activity we have been working on.  It is hard to avoid. This past week at the Tracz Family Band Hall project, we have been focused on acoustical treatment at the ceiling spaces. This is quite a messy process because you literally spray glue fibrous material at the ceiling and build up layers of material to achieve a 4” thick finished ceiling texture. This material is great for absorbing sound (like a band of 400 students playing together)! Without it in place the sound would echo off metal surfaces and create a very unpleasant experience. While it is coming along quite nicely, the pictures will be limited today because it’s hard to take a picture of a messy process and not think “wow, this is a mess”.

In addition to this process, plumbing systems are being insulated. Wall framing is now 95% complete with only small sections to complete where left out for access. Drywall installation continued in all areas, now starting to enclose walls and rooms. HVAC ductwork continued with some very large ductwork installed at the Band Hall room.  It’s amazing how much air flow is needed when the room is completely filled with people. Acoustical spray continued in all areas of the building.

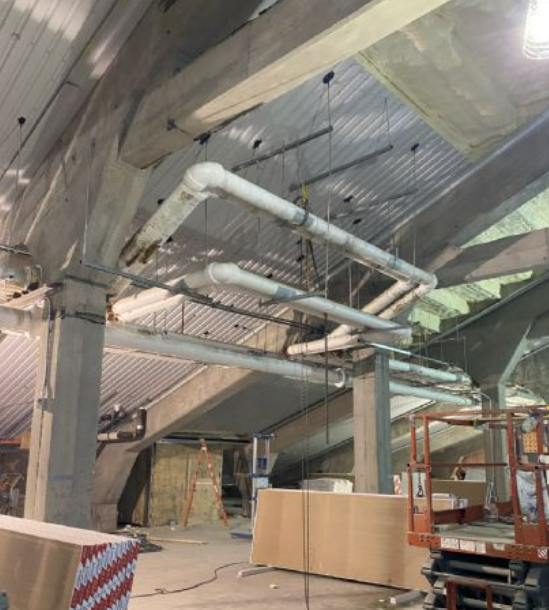

Next week’s plans: Fire protection piping will be installed. Drywall installation will continue and tape & finish crews will begin to smooth walls. Acoustical ceiling sprayed treatment should complete. Ductwork installation will continue with most areas completed in the next 2 weeks. The final air handling unit will be installed at the Mezzanine. Electricians will begin installation of lighting

2/19/23 - This past week on the Band Hall Project: The last couple of weeks on the Tracz Family Band Hall project has seen dramatic changes with the installation of the acoustical sprayed ceiling work.  This activity took center stage as it somewhat limits work area for other trades and ultimately touched about 90% of the project area. We are happy to report that this work is now behind us and though they did a really nice job, we are excited to be done with that piece of the project. We have about 2 months now until the project finish date and so timing for everything from here to the end will be important to maintain. Wall framing is now 100% complete. Drywall installation continued in all areas.  Rooms are now distinguishable, and you can really feel how this space will be used. HVAC ductwork continued with some very large ductwork and the last of the mechanical units set. Acoustical spray continued in all areas of the building. Field measurements were taken so cabinetry and wood paneling can be fabricated to exact dimensions. Electricians are busy installing final electrical raceways for future power and lighting. We patched and repaired the existing concrete walls leading to the new field access tunnels. Fire protection piping was installed in most all areas.

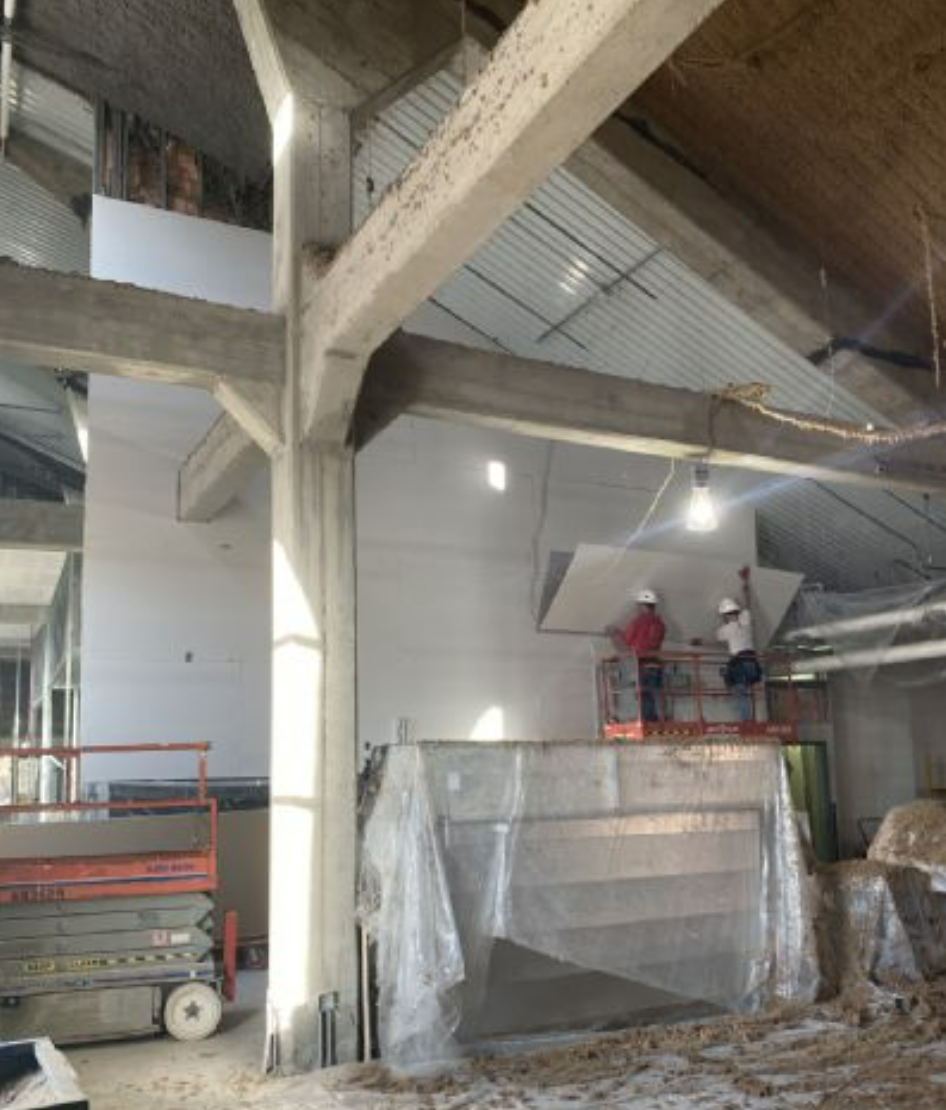

Next week’s plans: Drywall installation will complete, and tape & finish crews will be working to smooth walls. Painting will begin in exposed overhead conditions, then be moving to walls as they become available. Ductwork installation should complete will all large duct installed.  Once painting is done, they will fall back to install registers. Electricians will begin installation of lighting. Ceramic tile will begin in the restrooms. Aluminum windows and doors should begin later in the week. Site grading and utility tie-ins are expected to begin.

3/06/23 - This past week on the Band Hall Project: Drywall installation continued in the last few locations. Wall finishing is well underway now. Painting got started. HVAC ductwork continued with some very large ductwork installed near the mechanical mezzanine. Electricians are busy pulling wire through previously installed conduit.  We expect lights to be going up soon. We patched and repaired the existing walls to create the new Overhead Door opening at the west face of the building. Fire protection piping was installed. Site grading, paving base, and concrete walks. Concrete paving.

Next week’s plans: Drywall tape & finish crews will be working to smooth walls. Painting will continue in exposed overhead conditions, then be moving to walls as they become available. Electricians will begin installation of lighting. Ceramic tile will begin in the restrooms. Aluminum windows and doors should begin later in the week. Cabinetry installation should begin in the next 10 days. Mechanical unit start-up

3/19/23 - With less than 2-months remaining on the work schedule, activity on the Tracz Family Band Hall project is starting to accelerate on the building finishes. Painting is now an ongoing activity and we are starting to set cabinetry. More importantly, the mechanical and electrical systems are ready to start-up and this allows us to regulate the temperature and humidity in the building for even more finish material installations. We also took advantage of the lower student population during spring break to tidy up a few tie-in points at the site and interior spaces.

This past week on the Band Hall Project: Drywall finishing is just about complete. Only small limited work is left, strategically left open for access. Painting continued. Now working on large upper walls and overhead exposed spaces. Ceramic tile completed in the restroom areas. Cabinet installation started this past week. HVAC ductwork finished their installation of large ductwork on the mechanical mezzanine. Electricians are busy installing lights and are working on outlets and terminations at panels. protection piping is now finished and filled with water…be careful not to hit a sprinkler head now or you will be soaked. Concrete paving was tied into Denison Ave. The site is ready for final landscaping.

Next week’s plans: Painting will continue in exposed overhead conditions and walls. Electricians will continue installation of lighting. Aluminum windows and doors should begin later in the week. Cabinetry installation will continue. We hope to receive wood cabinets and wall veneer. We will make templates for solid surface countertops so those can be fabricated. Restroom accessories and toilet partitions will be installed. Mechanical unit start-up.

4/3/23 - Finish work is accelerating and the Tracz Family Band Hall project is really starting to show us all the color and material choices made months ago.  Lifts, excess materials, and tools are leaving the building in a sure sign that it’s time to complete the lower details and start preparing for final inspections.

This past week on the Band Hall Project: Drywall finishing in the last few touch-up locations. Painting continued. Now working on large upper walls and overhead exposed spaces. Cabinet installation continued this past week. Exterior doors and windows were installed. Electricians are busy installing lights and are working on outlets and terminations at panels. Floor covering started in the Uniform Storage space and will be progressing north in the building. We completed start up on the mechanical system and building controls.

Next week’s plans: Painting will continue on all surfaces. Electricians will continue installation of fire alarm devices, and other final electrical connections. Aluminum windows and door installation should wrap up later in the week. Finish carpentry will wrap up with installation of wood wall paneling and reception desk. We will make templates for solid surface countertops so those can be fabricated. Floor covering will continue. Doors and door hardware will be completed.

4/16/23 - It’s time to start finishing up final details, polishing the brass so to speak and getting the construction crews headed for the exit! The Band Hall project is entering its final stages and will soon be down to just a handful of completion items and final inspections. This doesn’t mean the next couple of weeks won’t be full of work because they will!

This past week on the Band Hall Project:

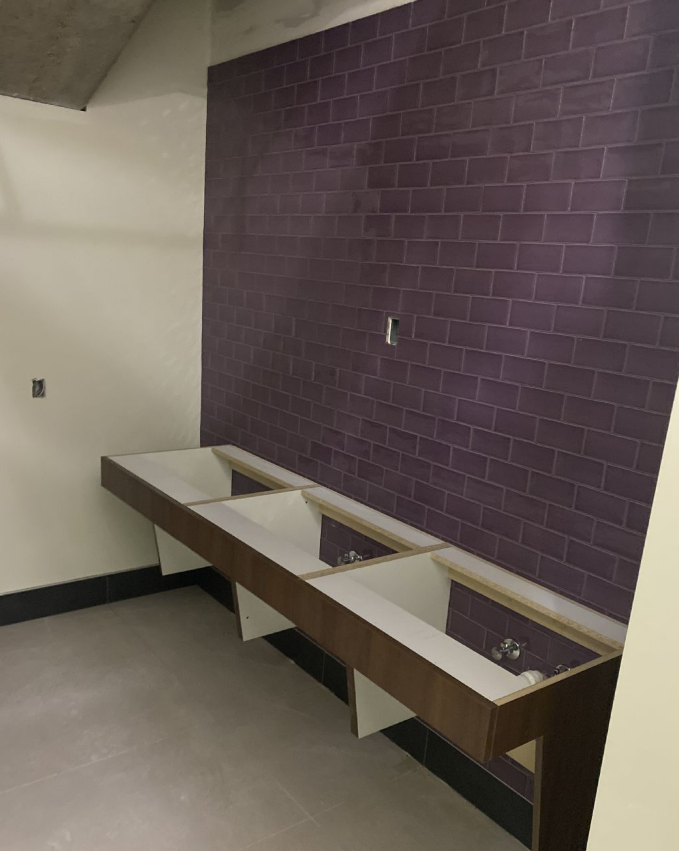

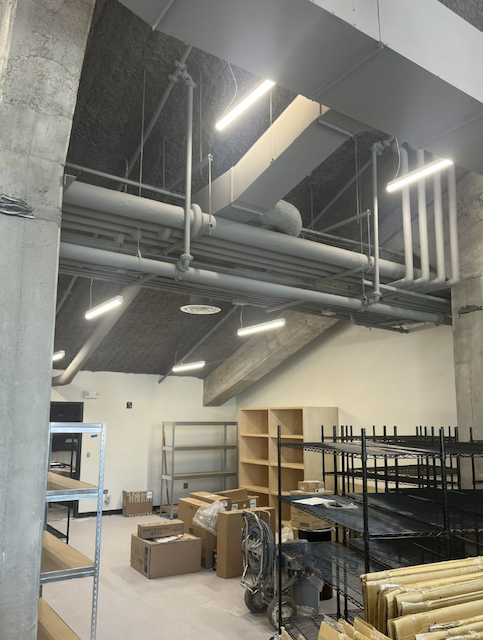

Started installation of acoustic wall and ceiling panels. Painting continued. Final wall colors are now on most walls. Carpenters were busy assembling wood paneling to create the trophy case. Instrument storage cabinets are being installed. Exterior doors and windows were installed. Electricians are busy installing fire alarm devices, lights, outlets and other electrical items. Floor covering work continued. Mechanical system testing continued. The controls systems are now operational.

Next week's plans:

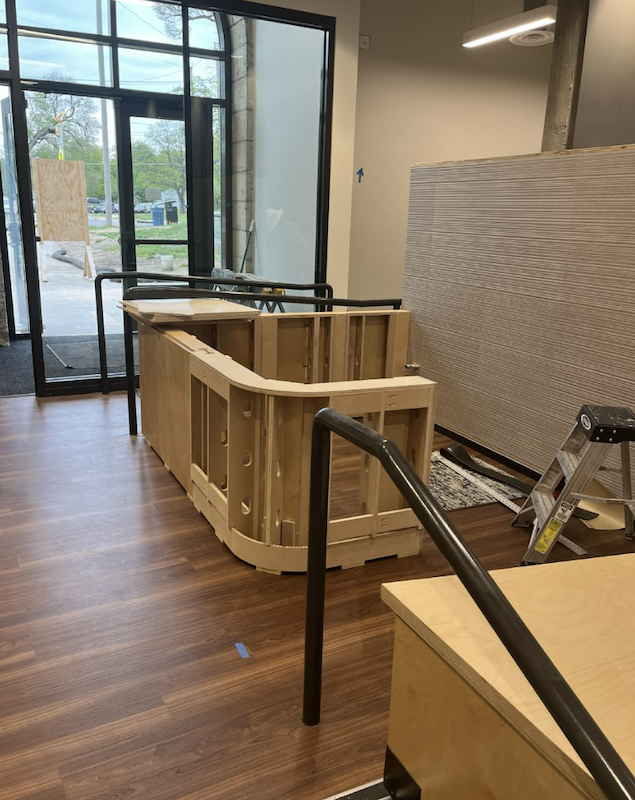

Painting will continue with most areas to receive a final coat of paint. Electricians should complete devices. Finish carpentry will wrap up with installation of wood wall paneling and reception desk. Solid surface countertops are due mid week for installation. Floor covering will continue at the entry and reception area. Ceiling tile will be installed. Acoustical panel installation will be completed.

5/2/23 - Cue the band! The KSU Band Hall project is in its final week of scheduled construction activity and as such, this will be the final update for this project. This has been a fun project together and something the future band students and instructors will benefit from for years. I personally don’t recall another project owner displaying outward enthusiasm for a project more than Dr. Tracz did on this one and honestly, that makes this one really rewarding. It’s been a busy couple of weeks since the last update and we are down to obtaining final inspections and making final adjustments to the details.

This past week on the Band Hall Project: Completed acoustic sound trap installation. Painting continued. Carpenters were busy assembling wood cabinetry, tops and wood paneling. Electricians are busy testing fire alarm systems, completing power for AV systems, and attending to details. Floor covering work completed Solid surface sills and tops were installed. Ceiling tiles are installed Final cleaning started. Hutton’s internal quality inspection list complete.

Next week’s plans: Punchlist completion. Final building inspections – Friday, May 5th. Reception desk installation. Training on building systems
